A project segment consists of three tasks. Task A is scheduled to begin at the start of Week 1 and finish at the end of

image text in transcribed

image text in transcribed

image text in transcribed

image text in transcribed

image text in transcribed

image text in transcribed

image text in transcribed

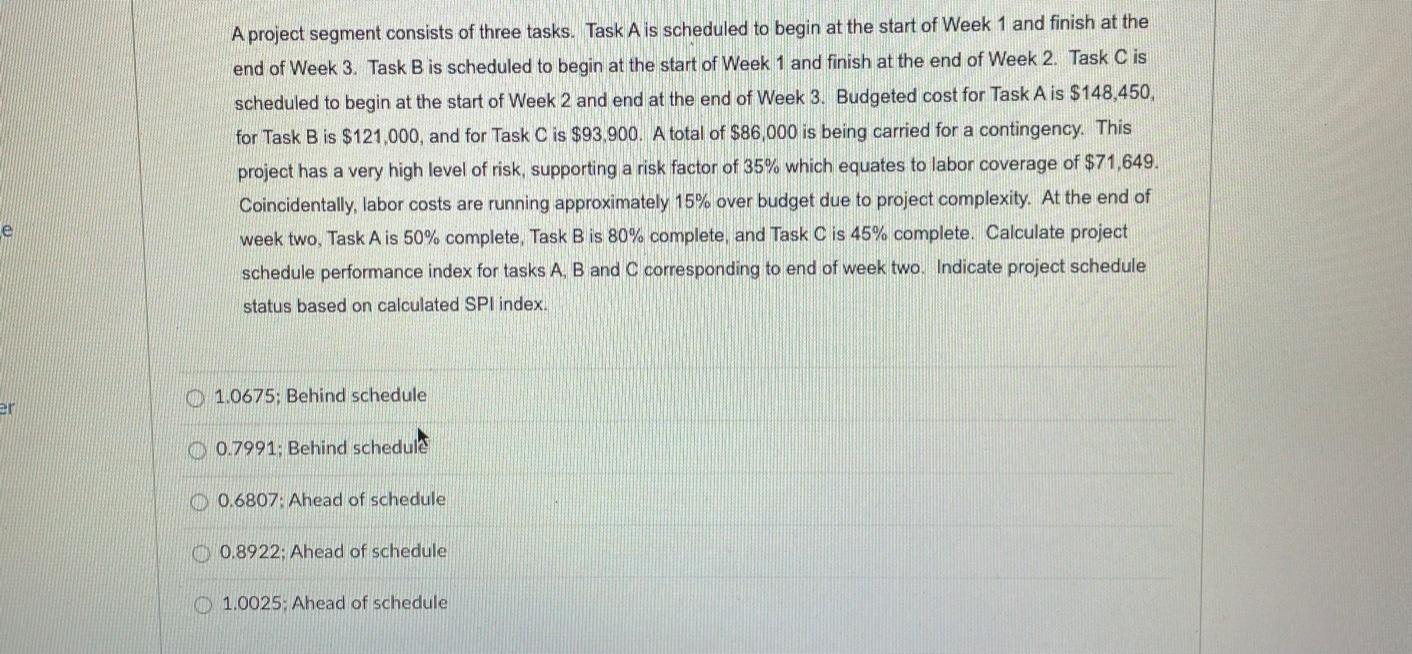

A project segment consists of three tasks. Task A is scheduled to begin at the start of Week 1 and finish at the end of Week 3. Task B is scheduled to begin at the start of Week 1 and finish at the end of Week 2 Task C is scheduled to begin at the start of Week 2 and end at the end of Week 3. Budgeted cost for Task A is $148,450, for Task B is $121,000, and for Task C is $93,900. A total of $86,000 is being carried for a contingency. This project has a very high level of risk, supporting a risk factor of 35% which equates to labor coverage of $71,649. Coincidentally, labor costs are running approximately 15% over budget due to project complexity. At the end of week two, Task A is 50% complete, Task B is 80% complete and Task C is 45% complete. Calculate project schedule performance index for tasks A, B and C corresponding to end of week two. Indicate project schedule status based on calculated SP index. 01.0675; Behind schedule er O 0.7991; Behind schedule 0.6807: Ahead of schedule 0.8922: Ahead of schedule 1.0025: Ahead of schedule A project segment consists of three tasks. Task A is scheduled to begin at the start of Week 1 and finish at the end of Week 3. Task B is scheduled to begin at the start of Week 1 and finish at the end of Week 2. Task C is scheduled to begin at the start of Week 2 and end at the end of Week 3. Budgeted cost for Task A is $148,450, for Task B is $121,000, and for Task C is $93.900. A total of $86,000 is being carried for a contingency. This project has a very high level of risk, supporting a risk factor of 35% which equates to labor coverage of $71,649. Coincidentally, labor costs are running approximately 15% over budget due to project complexity. At the end of week two, Task A is 50% complete, Task B is 80% complete, and Task C is 45% complete. Actual cost of work for tasks A, B and C performed at the end of week two for project segment is $151,000 and none of your allocated risk factor funds have been used. Labor costs remain over budget but are not getting worse. Balance of your contingency fund remains strong with $47,800 of $86,000 remaining. 100 percent of unused contingency is returned to the project owner. Calculate cost performance index for project segment. Indicate project budget status based on calculated CPI index. O 1.4125: Under budget 1.1355; Over budget * 0.9522: Under budget O 0.9522: Over budget O 0.8685; Under budget A construction company has total revenues on Project 8650 of $936,804, total construction costs of $729,332, labor costs of $208,000, material costs of $145,525, subcontractor costs of $328,744, equipment costs of $47,063, fixed overhead costs of $79,880, variable overhead costs of $52,490 and mixed overhead costs of $12,642 for the year. Risk factor assigned to this project is 24% with a minimum profit of 4.75%. Determine the company's percentage of construction revenues that became profits. 8.72% O 10.15% 0 4.75% 6.67% 09.52% A construction company has total revenues on Project 8650 of $936,804, total construction costs of $729,332, labor costs of $208,000, material costs of $145,525, subcontractor costs of $328,744, equipment costs of $47,063, fixed overhead costs of $79,880, variable overhead costs of $52,490 and mixed overhead costs of $12,642 for the year. Risk factor assigned to this project is 24% with a minimum profit of 4.75%. Assume revenue, construction costs, labor costs, material costs, subcontractor costs, equipment costs, fixed, mixed and variable overhead costs come in exactly (to the penny) of what was shown as a subtotal immediately before profit was figured and added to finalize your bid. Determine the company's percentage of costs that became profits. 4.75% CD 6.67% 8.94% 5.88% 07.14% Calculate break-even volume of work for a company with fixed overhead of $256,333, contribution margin ratio of 8.8%, risk factor of 25% and required profit level of $146,011. O $4,572,091 O $2,912,875 $1,659,216 $3,641,094 $5.715,114 A key goal of all construction companies is to: O contribute to local organizations in support of charitable causes O provide an accurate proforma indicating repayment terms of shareholder equity O assist project owners with cash flow management o provide a return on investment to shareholders a and d 1/.. U Question 33 4 pts A growing construction company should employ which of the following strategies in attaining sustainable, profitable growth? O Specialization Taking on marginally profitable projects O employee stock purchase plan to encourage staff retention o take on all possible projects regardless of profitability realizing volume of work increases bonding capacity all answers are solid strategies ge 20 Question 34 4 pts er Which of the following project management tools would be least likely to increase jobsite productivity? O Management By Walking Around (MBWA) Just in time delivery Weekly written performance evaluations for trade supervisors and trade workers Collaboration of all team members on schedule and performance milestones Sharing a "thanks for your hard work today MacBook Air
