Question

1 Approved Answer

EAC = estimate at completion, ETC = estimate to completion, CPI = cost performance index, SPI = schedule performance index, SV = schedule variance Earned

EAC = estimate at completion, ETC = estimate to completion, CPI = cost performance index, SPI = schedule performance index, SV = schedule varianceimage text in transcribed

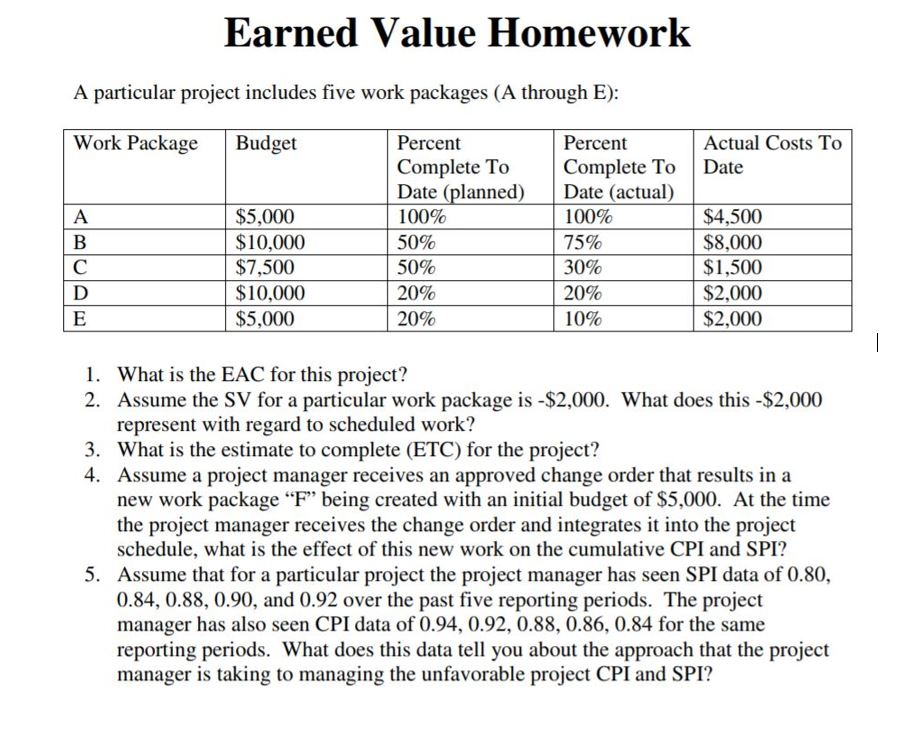

Earned Value Homework A particular project includes five work packages (A through E) Work Package Budget Percent Complete To Date (planned) 100% 50% 50% 20% 20% Percent Complete To Date Actual Costs To Date (actual) $5,000 $10,000 $7,500 $10,000 $5,000 100% 75% 30% 20% 10% $4,500 $8,000 $1,500 $2,000 $2,000 1. What is the EAC for this project? 2. Assume the SV for a particular work package is-$2,000. What does this -$2,000 represent with regard to scheduled work? What is the estimate to complete (ETC) for the project? Assume a project manager receives an approved change order that results ina new work package "F" being created with an initial budget of $5,000. At the time the project manager receives the change order and integrates it into the project schedule, what is the effect of this new work on the cumulative CPI and SPI? Assume that for a particular project the project manager has seen SPI data of 0.80 0.84, 0.88, 0.90, and 0.92 over the past five reporting periods. The project manager has also seen CPI data of 0.94, 0.92, 0.88, 0.86, 0.84 for the same reporting periods. What does this data tell you about the approach that the project manager is taking to managing the unfavorable project CPI and SPI? 3. 4. 5. Earned Value Homework A particular project includes five work packages (A through E) Work Package Budget Percent Complete To Date (planned) 100% 50% 50% 20% 20% Percent Complete To Date Actual Costs To Date (actual) $5,000 $10,000 $7,500 $10,000 $5,000 100% 75% 30% 20% 10% $4,500 $8,000 $1,500 $2,000 $2,000 1. What is the EAC for this project? 2. Assume the SV for a particular work package is-$2,000. What does this -$2,000 represent with regard to scheduled work? What is the estimate to complete (ETC) for the project? Assume a project manager receives an approved change order that results ina new work package "F" being created with an initial budget of $5,000. At the time the project manager receives the change order and integrates it into the project schedule, what is the effect of this new work on the cumulative CPI and SPI? Assume that for a particular project the project manager has seen SPI data of 0.80 0.84, 0.88, 0.90, and 0.92 over the past five reporting periods. The project manager has also seen CPI data of 0.94, 0.92, 0.88, 0.86, 0.84 for the same reporting periods. What does this data tell you about the approach that the project manager is taking to managing the unfavorable project CPI and SPI? 3. 4. 5

Step by Step Solution

There are 3 Steps involved in it

Step: 1

blur-text-image

Get Instant Access to Expert-Tailored Solutions

See step-by-step solutions with expert insights and AI powered tools for academic success

Step: 2

blur-text-image

Step: 3

blur-text-image

Ace Your Homework with AI

Get the answers you need in no time with our AI-driven, step-by-step assistance

Get Started

Recommended Textbook for

Managerial Accounting

Authors: Cataldo Cpa II, Cma Cgma A J

2nd Edition

1634929241, 978-1634929240

More Books

Students also viewed these Accounting questions

Question

Explain the link between positive thinking and good health.

Answered: 1 week ago

Question

Outline the regulatory framework for workplace health and safety

Answered: 1 week ago
