Answered step by step
Verified Expert Solution
Question
1 Approved Answer

EVM Assignment Answer At SUGGESTION Go back and review week 6 (chapter 7 of the textbook) AND watch the EVM videos from week 6. NOTE

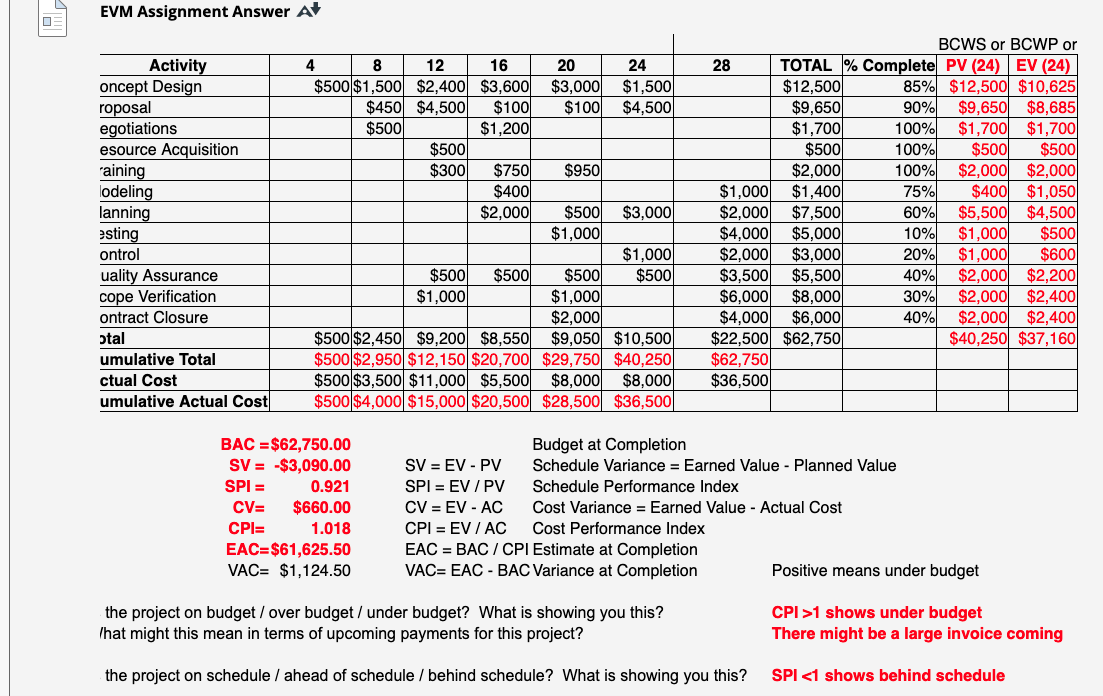

EVM Assignment Answer At SUGGESTION Go back and review week 6 (chapter 7 of the textbook) AND watch the EVM videos from week 6. NOTE This assignment is a little different than presented in the textbook and videos so it will take some thinking. A project manager surveyed his earned value table at the conclusion of month 24 . The results are shown in the table below. (\$ values shown). The planned payment schedule is shown with \% Complete which can be used to calculate earned value for each activity. Pay attention to the Actual Costs (payments). Copy the table below into Excel and show your work by expanding or adding the necessary rows and columns and fill in as nee Add a small table at the end for these items: - Calculate the Total Budget at Completion ( BAC ) for the project - Calculate the Schedule Variance and the SPI for this project at the end of the 24th month - Calculate the Cost Variance and the CPI for the project at the end of the 24th month - Calculate the Estimate at Completion - Is the project on budget / over budget / under budget? What is showing you this? What might this mean in terms of upcoming payments for this project? Is the project on schedule / ahead of schedule / behind schedule? What is showing you this? Submit the result as a single MS Excel spreadsheet with your name in cell A1 and your student number in cell B1
Step by Step Solution
There are 3 Steps involved in it
Step: 1
Get Instant Access to Expert-Tailored Solutions
See step-by-step solutions with expert insights and AI powered tools for academic success
Step: 2
Step: 3
Ace Your Homework with AI
Get the answers you need in no time with our AI-driven, step-by-step assistance
Get Started
