SUBJECT OPERATION RESEARCH ( START OFF BY DESIGNING THE NETWORK USING THE CRITICAL PATH METHOD show how to calculate late finish TOPIC : PROJECT MANAGEMENT
SUBJECT OPERATION RESEARCH ( START OFF BY DESIGNING THE NETWORK USING THE CRITICAL PATH METHOD show how to calculate late finish TOPIC : PROJECT MANAGEMENT

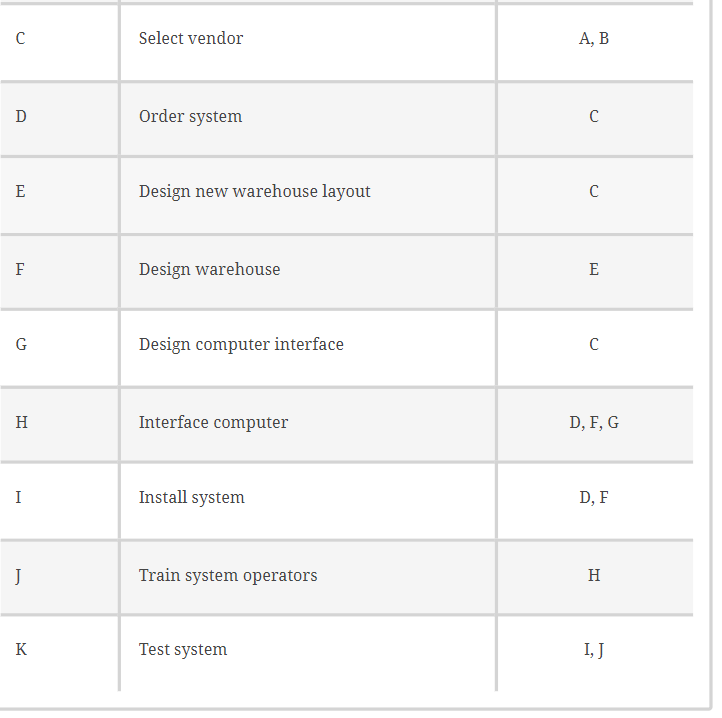

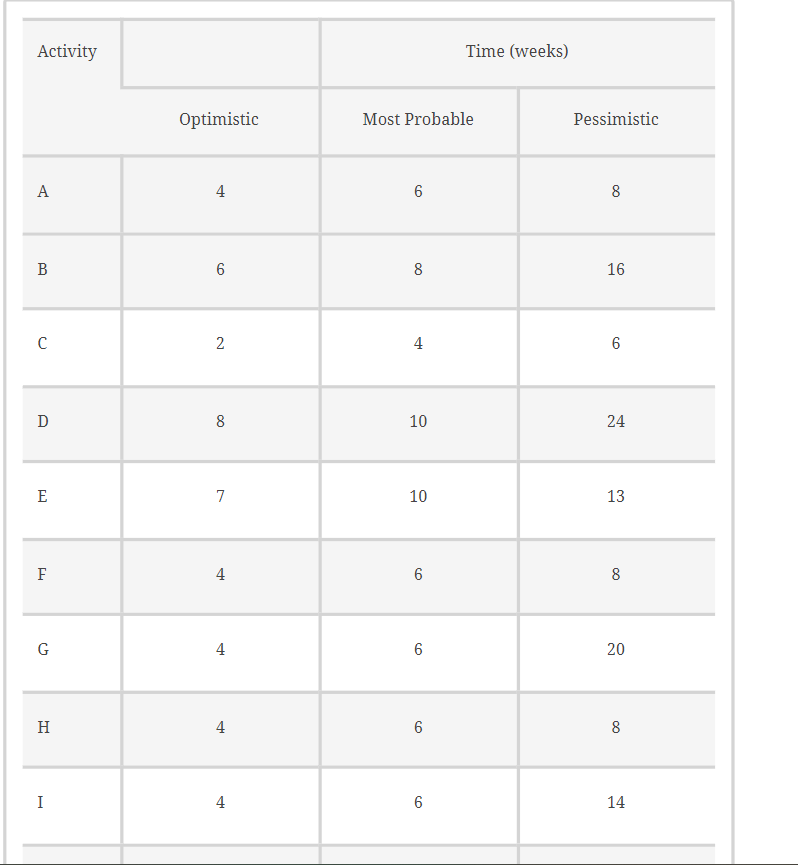

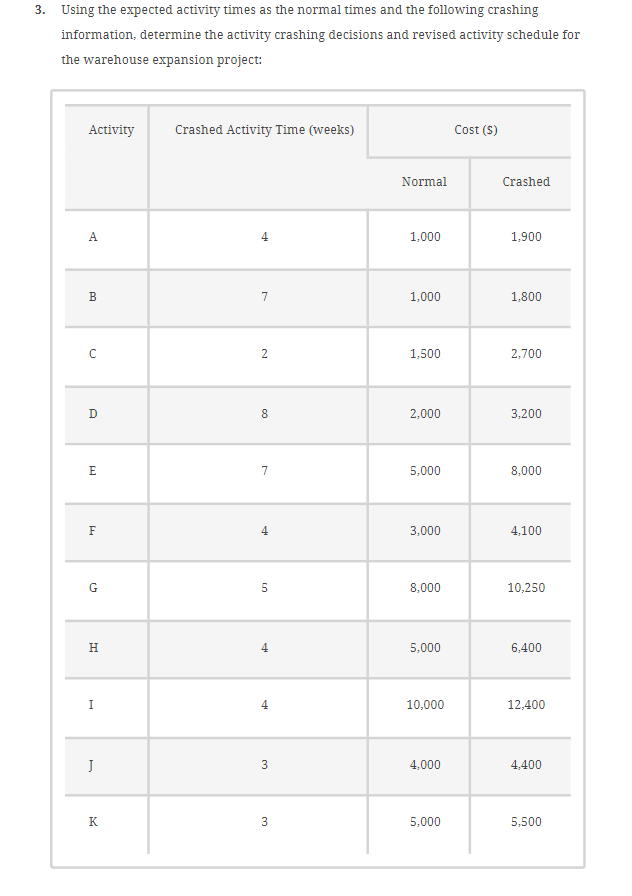

Case Problem R. C. Coleman R. C. Coleman distributes a variety of food products that are sold through grocery store and supermarket outlets. The company receives orders directly from the individual outlets, with a typical order requesting the delivery of several cases of anywhere from 20 to 50 different products. Under the company's current warehouse operation, warehouse clerks dispatch order-picking personnel to fill each order and have the goods moved to the warehouse shipping area. Because of the high lahor costs and relatively low productivity of hand order- picking, management has decided to automate the warehouse operation by installing a computer-controlled order-picking system, along with a conveyor system for moving goods from storage to the warehouse shipping area. R. C. Coleman's director of material management has been named the project manager in charge of the automated warehouse system. After consulting with members of the engineering staff and warehouse management personnel, the director compiled a list of activities associated with the project. The optimistic, most probable, and pessimistic times (in weeks) have also heen provided for each activity. Activity Description Immediate Predecessor A Determine equipment needs B Obtain vendor proposals C Select vendor AR Select vendor Order system Design new warehouse layout Design warehouse Design computer interface Interface computer Install system Train system operators Test system L] Activity Time (weeks) Optimistic Most Probable Pessimistic A 6 8 B 6 8 16 C 6 D 10 24 10 13 4 6 8 G 4 6 20 H 8 H 4 6 14Managerial Report Develop a report that presents the activity schedule and expected project completion time for the warehouse expansion project. Include a project network in the report. In addition, take into consideration the following issues: 1. R. C. Coleman's top management established a required 40-week completion time for the project. Can this completion time be achieved? Include probability information in your discussion. What recommendations do you have if the 40-week completion time is required? Suppose that management requests that activity times be shortened to provide an 80% chance of meeting the 40-week completion time. If the variance in the project completion time is the same as you found in part (1), how much should the expected project completion time be shortened to achieve the goal of an 80% chance of completion within 40 weeks? Using the expected activity times as the normal times and the following crashing information, determine the activity crashing decisions and revised activity schedule for the warehouse expansion project: Activity Crashed Activity Time (weeks) Cost ($) 3. Using the expected activity times as the normal times and the following crashing information, determine the activity crashing decisions and revised activity schedule for the warehouse expansion project Activity Crashed Activity Time (weeks) A 4 B T c z D 8 E - F 4 G 5 H 4 1 4 3 Normal 1.000 1.000 1.500 2,000 5.000 3,000 8.000 .000 10,000 4,000 5.000 Crashed 1,500 1,800 2.700 3.200 8,000 4,100 10.250 .400 12,400 4.400Step by Step Solution
There are 3 Steps involved in it
Step: 1
Get Instant Access to Expert-Tailored Solutions
See step-by-step solutions with expert insights and AI powered tools for academic success
Step: 2
Step: 3
Ace Your Homework with AI
Get the answers you need in no time with our AI-driven, step-by-step assistance
Get Started
