Above are some material to help with the question, Question to be solved is problem 47 This is problem from Production and operation analysis, 7th
Above are some material to help with the question, Question to be solved is problem 47
This is problem from Production and operation analysis, 7th edition, chapter 8, problem 47. Please answer this with instruction to solve this problem with spreadsheet.

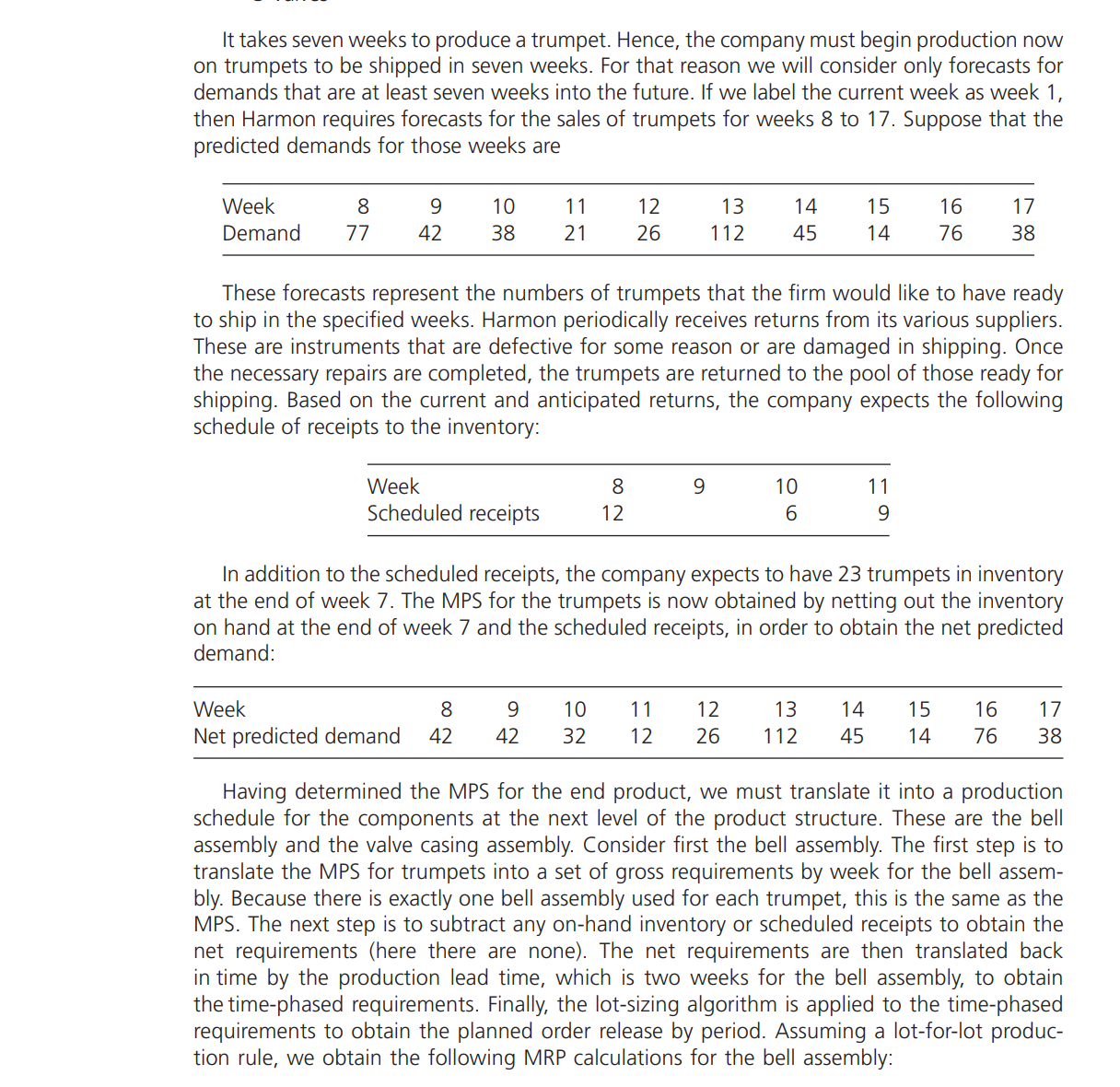

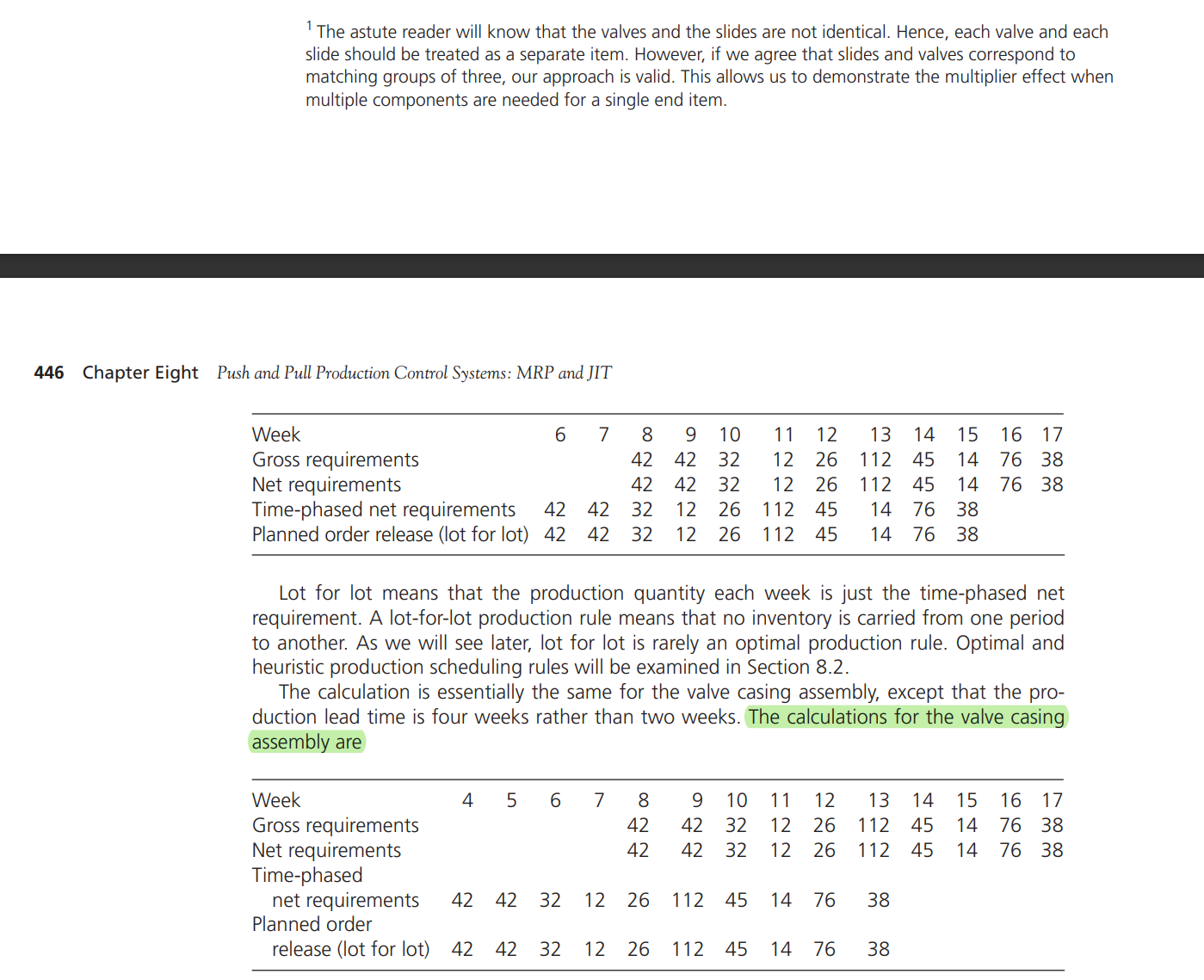

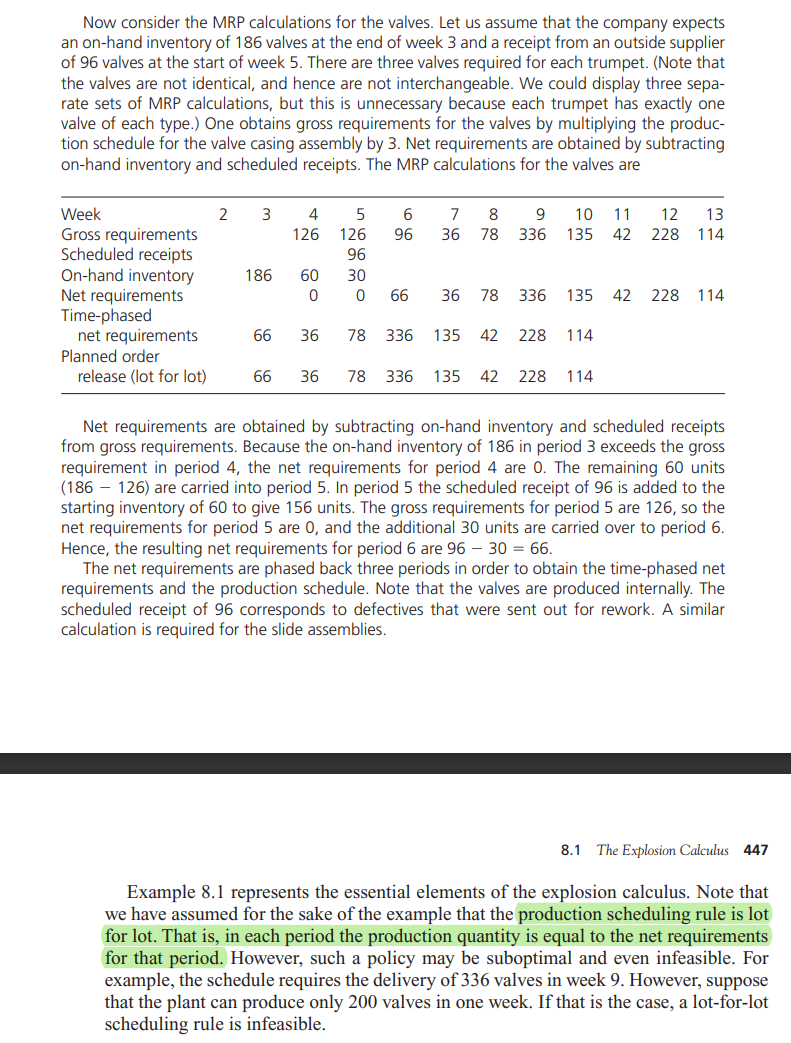

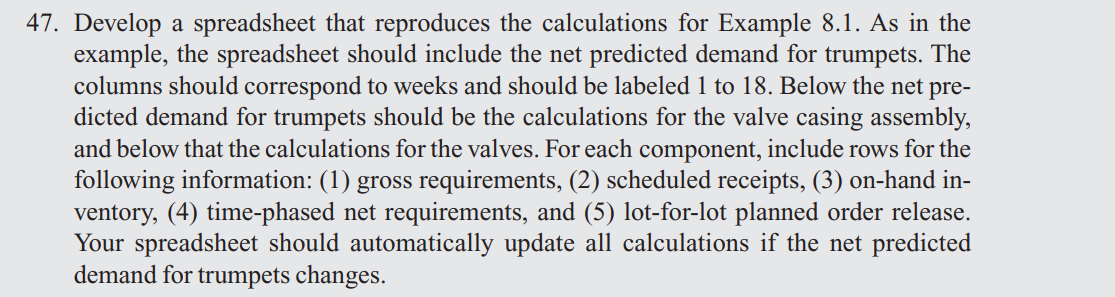

Example 8.1 The Harmon Music Company produces a variety of wind instruments at its plant in Joliet, Illinois. Because the company is relatively small, it would like to minimize the amount of money tied up in inventory. For that reason production levels are set to match predicted demand as closely as possible. In order to achieve this goal, the company has adopted an MRP system to determine production quantities. One of the instruments produced is the model 85C trumpet. The trumpet retails for $800 and has been a reasonably, if not spectacularly, profitable item for the company. Based on orders from music stores around the country, the production manager receives predictions of future demand for about four months into the future. Figure 8-4 shows the trumpet and its various subassemblies. Figure 85 gives the product structure diagram for the construction of the trumpet. The bell section and the lead pipe and valve sections are welded together in final assembly. Before the welding, three slide assemblies and three valves are produced and fitted to the valve casing assembly. The forming and shaping of the bell section requires two weeks, and the forming and shaping of the lead pipe and valve sections require four weeks. The valves require three weeks to produce, and the slide assemblies two weeks. The trumpet assembly problem is a three-level MRP system. Level 0 corresponds to the final product or end item, which is the completed trumpet. Level 1, the child level relative to the trumpet, corresponds to the bell and valve casing assemblies. Level 2 corresponds to the slide FIGURE 8-4 Trumpet and subassemblies 8.1 The Explosion Calculus 445 and valve assemblies. The information in the product structure diagram is often represented as an indented bill of materials (BOM), which is a more convenient representation for preparation of computer input. The indented BOM for the trumpet is 1 1 Trumpet 1 Bell assembly 1 Valve assembly 3 Slide assemblies 3 Valves It takes seven weeks to produce a trumpet. Hence, the company must begin production now on trumpets to be shipped in seven weeks. For that reason we will consider only forecasts for demands that are at least seven weeks into the future. If we label the current week as week 1 , then Harmon requires forecasts for the sales of trumpets for weeks 8 to 17 . Suppose that the predicted demands for those weeks are These forecasts represent the numbers of trumpets that the firm would like to have ready to ship in the specified weeks. Harmon periodically receives returns from its various suppliers. These are instruments that are defective for some reason or are damaged in shipping. Once the necessary repairs are completed, the trumpets are returned to the pool of those ready for shipping. Based on the current and anticipated returns, the company expects the following schedule of receipts to the inventory: In addition to the scheduled receipts, the company expects to have 23 trumpets in inventory at the end of week 7. The MPS for the trumpets is now obtained by netting out the inventory on hand at the end of week 7 and the scheduled receipts, in order to obtain the net predicted demand: Having determined the MPS for the end product, we must translate it into a production schedule for the components at the next level of the product structure. These are the bell assembly and the valve casing assembly. Consider first the bell assembly. The first step is to translate the MPS for trumpets into a set of gross requirements by week for the bell assembly. Because there is exactly one bell assembly used for each trumpet, this is the same as the MPS. The next step is to subtract any on-hand inventory or scheduled receipts to obtain the net requirements (here there are none). The net requirements are then translated back in time by the production lead time, which is two weeks for the bell assembly, to obtain the time-phased requirements. Finally, the lot-sizing algorithm is applied to the time-phased requirements to obtain the planned order release by period. Assuming a lot-for-lot production rule, we obtain the following MRP calculations for the bell assembly: 1 The astute reader will know that the valves and the slides are not identical. Hence, each valve and each slide should be treated as a separate item. However, if we agree that slides and valves correspond to matching groups of three, our approach is valid. This allows us to demonstrate the multiplier effect when multiple components are needed for a single end item. 446 Chapter Eight Push and Pull Production Control Systems: MRP and JIT Lot for lot means that the production quantity each week is just the time-phased net requirement. A lot-for-lot production rule means that no inventory is carried from one period to another. As we will see later, lot for lot is rarely an optimal production rule. Optimal and heuristic production scheduling rules will be examined in Section 8.2. The calculation is essentially the same for the valve casing assembly, except that the production lead time is four weeks rather than two weeks. The calculations for the valve casing assembly are Now consider the MRP calculations for the valves. Let us assume that the company expects an on-hand inventory of 186 valves at the end of week 3 and a receipt from an outside supplier of 96 valves at the start of week 5 . There are three valves required for each trumpet. (Note that the valves are not identical, and hence are not interchangeable. We could display three separate sets of MRP calculations, but this is unnecessary because each trumpet has exactly one valve of each type.) One obtains gross requirements for the valves by multiplying the production schedule for the valve casing assembly by 3 . Net requirements are obtained by subtracting on-hand inventory and scheduled receipts. The MRP calculations for the valves are Net requirements are obtained by subtracting on-hand inventory and scheduled receipts from gross requirements. Because the on-hand inventory of 186 in period 3 exceeds the gross requirement in period 4 , the net requirements for period 4 are 0 . The remaining 60 units (186126) are carried into period 5 . In period 5 the scheduled receipt of 96 is added to the starting inventory of 60 to give 156 units. The gross requirements for period 5 are 126 , so the net requirements for period 5 are 0 , and the additional 30 units are carried over to period 6 . Hence, the resulting net requirements for period 6 are 9630=66. The net requirements are phased back three periods in order to obtain the time-phased net requirements and the production schedule. Note that the valves are produced internally. The scheduled receipt of 96 corresponds to defectives that were sent out for rework. A similar calculation is required for the slide assemblies. 8.1 The Explosion Calculus 447 Example 8.1 represents the essential elements of the explosion calculus. Note that we have assumed for the sake of the example that the production scheduling rule is lot for lot. That is, in each period the production quantity is equal to the net requirements for that period. However, such a policy may be suboptimal and even infeasible. For example, the schedule requires the delivery of 336 valves in week 9 . However, suppose that the plant can produce only 200 valves in one week. If that is the case, a lot-for-lot scheduling rule is infeasible. 7. Develop a spreadsheet that reproduces the calculations for Example 8.1. As in the example, the spreadsheet should include the net predicted demand for trumpets. The columns should correspond to weeks and should be labeled 1 to 18 . Below the net predicted demand for trumpets should be the calculations for the valve casing assembly, and below that the calculations for the valves. For each component, include rows for the following information: (1) gross requirements, (2) scheduled receipts, (3) on-hand inventory, (4) time-phased net requirements, and (5) lot-for-lot planned order release. Your spreadsheet should automatically update all calculations if the net predicted demand for trumpets changesStep by Step Solution
