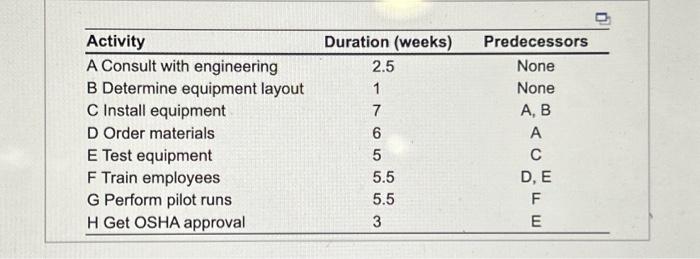

\begin{tabular}{lcc} \hline Activity & Duration (weeks) & Predecessors \\ \hline A Consult with engineering & 2.5 & None \\ B Determine equipment layout & 1 & None \\ C Install equipment & 7 & A,B \\ D Order materials & 6 & A \\ E Test equipment & 5 & C \\ F Train employees & 5.5 & D,E \\ G Perform pilot runs & 5.5 & F \\ H Get OSHA approval & 3 & E \\ \hline \end{tabular} Calculate the early start and early finish times for each activity. Fill in the table below (enter your rosponses roundod to one decimal place). \begin{tabular}{cccc} \hline Activity & Duration (weeks) & Predecessors & ES \\ \hline A & 2.5 & None & \\ B & 1 & None & \\ C & 7 & A.B & \\ D & 6 & A & \\ E & 5 & C & \\ F & 5.5 & D, E & \\ C & 5.5 & F & \\ H & 3 & E & \end{tabular} Calculate the late start and late finish tmes for the each activity performing the backward pass. Fill in the tablo tolow (enter your rosponses rounded fo one docima/placo) \begin{tabular}{|c|c|c|c|c|} \hline Activity & Duration (weeks) & Predecessors & LS & LF \\ \hline H & 3 & E & & \\ \hline o & 5.5 & F & & \\ \hline F & 5.5 & D, E & E & \\ \hline E & 5 & c & & \\ \hline 0 & 6 & A & E & \\ \hline c & 7 & A,B & & \\ \hline B & 1 & None & & \\ \hline A & 2.6 & Nane. & & \\ \hline \end{tabular} recording software onto a CD. You have identhled several activities that must take place before this "burn-in" process is ready to use: Cick the icon to view the actinties. a. Choose the correct project nebwork diagram below. A. 8. c. o. Calculate the early start and early finish times for each activity Fat in the table below (enfer your responses rounded to one decimal place). b. Every week of delay in the propect cosis your company $500. Suppose you know the following: (1) Activin G can be crashed by if week, as a cest of $2,000; (2) activit A can be cashed by 1,5 wetks, int a totil cost of only $250, and (3) activity C can be crashed by 1 week, at a cost of $2,500. Managemeet should crash activity(/es) The compary wil suve 1 (Enter your response as a whole number)
