Question
Question 1 You decide to start your analysis by examining how throughput time changes as utilization increases. Open the HW3 Excel file. Click on the
Question 1
You decide to start your analysis by examining how throughput time changes as utilization increases. Open the HW3 Excel file. Click on the tab labeled Questions 1. In the spreadsheet for Question 1, a coefficient of variation (CV) of 1.0 is used to determine the Interarrival time and total processing time (including setup) variance. The formulas to determine the Throughput Time have already been entered for you.
1a. (12 points) Identify the formulas in the green cells B9-B14. B8 is the level of description needed for each cell.
Cell | Description | Formula (Description and Numbers) |
B8 | Batch Processing Time | Set-up Time + (Batch Size * Processing Time/Part) |
35 + (400 * 3) = 1,235 minutes per batch | ||
B9 | Interarrival Time | |
B10 | Arrival rate (batches/week) | |
B11 | Capacity (batches/week) | |
B12 | Capacity (parts/week) | |
B13 | Throughput Rate (batches/week) | |
B14 | Throughput Rate (parts/week) | |
1b. (10 points) Plot the Throughput Time as a line graph (created using the scatter chart in Excel) that has Utilization on the horizontal axis and Throughput Time on the vertical axis.

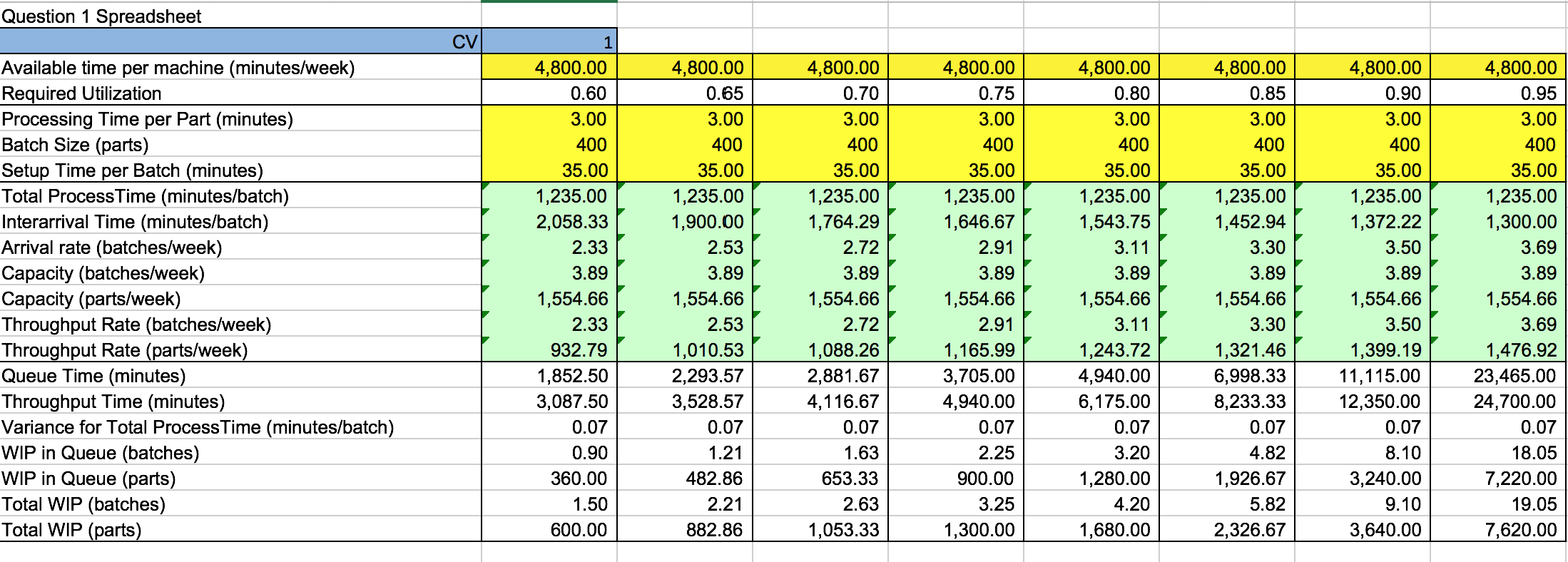

Question 1 Spreadsheet CV 4,800.00 0.85 3.00 Available time per machine (minutes/week) Required Utilization Processing Time per Part (minutes) Batch Size (parts) Setup Time per Batch (minutes) Total Process Time (minutes/batch) Interarrival Time (minutes/batch) Arrival rate (batches/week) Capacity (batches/week) Capacity (parts/week) Throughput Rate (batches/week) Throughput Rate (parts/week) Queue Time (minutes) Throughput Time (minutes) Variance for Total Process Time (minutes/batch) WIP in Queue (batches) WIP in Queue (parts) Total WIP (batches) Total WIP (parts) 4,800.00 0.60 3.00 400 35.00 1,235.00 2,058.33 2.33 3.89 1,554.66 2.33 932.79 1,852.50 3,087.50 0.07 0.90 360.00 1.50 600.00 4,800.00 0.65 3.00 400 35.00 1,235.00 1,900.00 2.53 3.89 1,554.66 2.53 1,010.53 2,293.57 3,528.57 0.07 4,800.00 0.70 3.00 400 35.00 1,235.00 1,764.29 2.72 3.89 1,554.66 2.72 1,088.26 2,881.67 4,116.67 0.07 1.63 653.33 2.63 1,053.33 4,800.00 0.75 3.00 400 35.00 1,235.00 1,646.67 2.91 3.89 1,554.66 2.91 1,165.99 3,705.00 4,940.00 0.07 2.25 900.00 3.25 1,300.00 4,800.00 0.80 3.00 400 35.00 1,235.00 1,543.75 3.11 3.89 1,554.66 3.11 1,243.72 4,940.00 6,175.00 0.07 3.20 1,280.00 4.20 1,680.00 400 35.00 1,235.00 1,452.94 3.30 3.89 1,554.66 3.30 1.321.46 6,998.33 8,233.33 0.07 4.82 1,926.67 4,800.00 0.90 3.00 400 35.00 1,235.00 1.372.22 3.50 3.89 1,554.66 3.50 1,399.19 11,115.00 12,350.00 0.07 8.10 3,240.00 9.10 3,640.00 4,800.00 0.95 3.00 400 35.00 1,235.00 1,300.00 3.69 3.89 1,554.66 3.69 1.476.92 23,465.00 24,700.00 0.07 18.05 7,220.00 19.05 7,620.00 1.21 482.86 2.21 882.86 5.82 2,326.67 Question 1 Spreadsheet CV 4,800.00 0.85 3.00 Available time per machine (minutes/week) Required Utilization Processing Time per Part (minutes) Batch Size (parts) Setup Time per Batch (minutes) Total Process Time (minutes/batch) Interarrival Time (minutes/batch) Arrival rate (batches/week) Capacity (batches/week) Capacity (parts/week) Throughput Rate (batches/week) Throughput Rate (parts/week) Queue Time (minutes) Throughput Time (minutes) Variance for Total Process Time (minutes/batch) WIP in Queue (batches) WIP in Queue (parts) Total WIP (batches) Total WIP (parts) 4,800.00 0.60 3.00 400 35.00 1,235.00 2,058.33 2.33 3.89 1,554.66 2.33 932.79 1,852.50 3,087.50 0.07 0.90 360.00 1.50 600.00 4,800.00 0.65 3.00 400 35.00 1,235.00 1,900.00 2.53 3.89 1,554.66 2.53 1,010.53 2,293.57 3,528.57 0.07 4,800.00 0.70 3.00 400 35.00 1,235.00 1,764.29 2.72 3.89 1,554.66 2.72 1,088.26 2,881.67 4,116.67 0.07 1.63 653.33 2.63 1,053.33 4,800.00 0.75 3.00 400 35.00 1,235.00 1,646.67 2.91 3.89 1,554.66 2.91 1,165.99 3,705.00 4,940.00 0.07 2.25 900.00 3.25 1,300.00 4,800.00 0.80 3.00 400 35.00 1,235.00 1,543.75 3.11 3.89 1,554.66 3.11 1,243.72 4,940.00 6,175.00 0.07 3.20 1,280.00 4.20 1,680.00 400 35.00 1,235.00 1,452.94 3.30 3.89 1,554.66 3.30 1.321.46 6,998.33 8,233.33 0.07 4.82 1,926.67 4,800.00 0.90 3.00 400 35.00 1,235.00 1.372.22 3.50 3.89 1,554.66 3.50 1,399.19 11,115.00 12,350.00 0.07 8.10 3,240.00 9.10 3,640.00 4,800.00 0.95 3.00 400 35.00 1,235.00 1,300.00 3.69 3.89 1,554.66 3.69 1.476.92 23,465.00 24,700.00 0.07 18.05 7,220.00 19.05 7,620.00 1.21 482.86 2.21 882.86 5.82 2,326.67
Step by Step Solution
There are 3 Steps involved in it
Step: 1
Get Instant Access to Expert-Tailored Solutions
See step-by-step solutions with expert insights and AI powered tools for academic success
Step: 2
Step: 3
Ace Your Homework with AI
Get the answers you need in no time with our AI-driven, step-by-step assistance
Get Started
